Genuine Gas Engine Part on Backorder? Five Ways Around a Long Lead Time

Views: 0     Author: Weyeah Power     Publish Time: 2026-10-29      Origin: Site

Inquire

facebook sharing button
twitter sharing button
line sharing button
wechat sharing button
linkedin sharing button
pinterest sharing button
whatsapp sharing button
sharethis sharing button

When a genuine part goes on backorder, you have five realistic moves: push the OEM order, look for regional stock, fit an aftermarket part, use a reconditioned part, or change how the engine runs until the part arrives. Choosing an alternative to a genuine part with a long lead time is a risk decision, not a price decision. Start with how critical the part is.

What a long lead time actually costs you

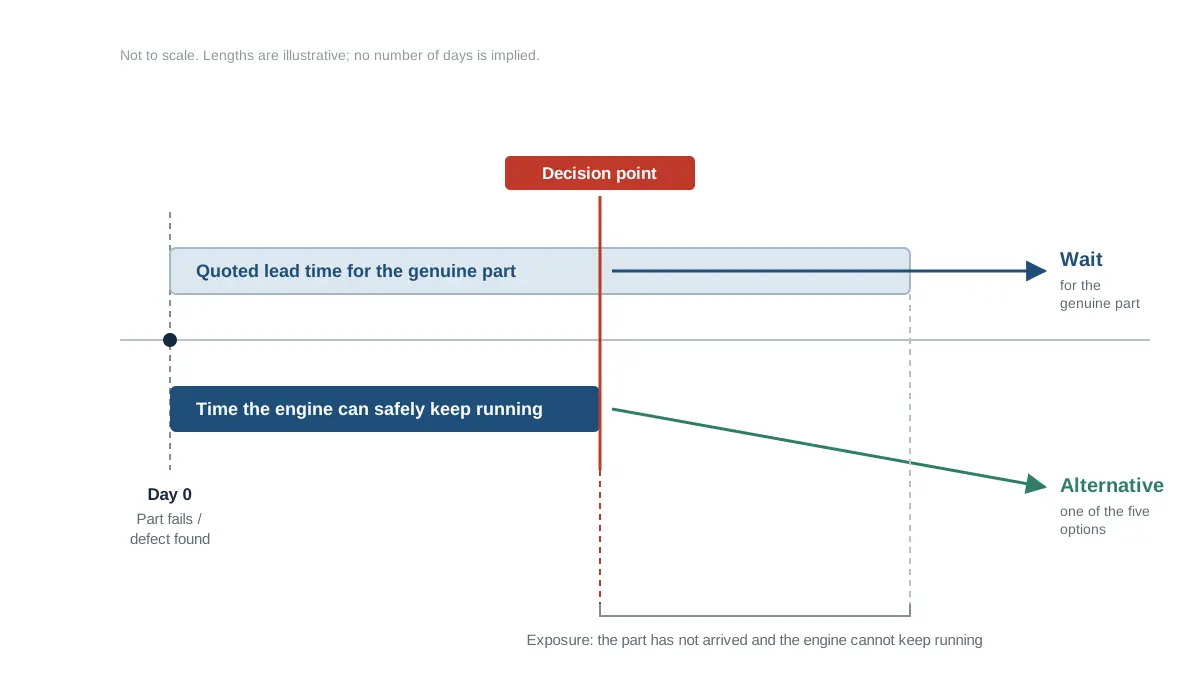

A quoted lead time only matters next to two other numbers you already know: how long the engine can stay in its current state, and what each day of lost output is worth. Write both down before you compare options.

Three situations look similar on a quotation and behave very differently in practice.

  • The engine is down. Every day of lead time is lost generation. Here the question is which option restores safe operation soonest.

  • The engine is running, but on a known defect. You have a window, and the size of that window is a technical judgement, not a procurement one.

  • The part is a planned replacement. Nothing is at risk yet, and waiting is usually the cheapest answer.

The third case rarely needs an alternative. The first two are where this article is useful.


Five alternatives when the genuine part has a long lead time

Each row below is a real option. None of them is automatically right, and the last one is not a repair.

Option

What it means

Where it helps

What to watch

1. Push the OEM order

Ask for priority allocation, a partial or split shipment, or faster transport on the same order

The part is unique, safety critical, or covered by an agreement that requires it

Costs rise; a promised date can still move. Get the revised date in writing

2. Look for regional stock

The same part may sit with another distributor, another plant in your group, or a stockholder in your region

Common service parts that several sites hold

Confirm the part number, storage age and condition. Ask what the item actually is before you pay

3. Fit an aftermarket part

A compatible part from an independent supplier, matched on fit, form and function

The part is standard enough to verify, and the wait is longer than you can carry

Verification work moves to you. See the checklist below, and aftermarket alternatives to genuine parts

4. Use a reconditioned or exchange part

A used component that has been inspected, reworked and released, often against a core return

Large components, and parts the manufacturer no longer supplies

Ask what was measured, what was replaced and what the release criteria were. Condition varies between suppliers

5. Change how the engine runs

Reduced load, a shorter running window, or a planned stop, agreed with a qualified engineer and within the manufacturer's documented limits

Buying time while a better option is organised

This manages risk, it does not remove it. Never improvise an operating limit to avoid a purchase

Options 1 to 4 can be combined. Operators often order the genuine part anyway, fit an alternative to get back online, and keep the genuine part as the next spare.


Decide by criticality, not by the quotation

Work through these questions in order. They take ten minutes and they settle most arguments between maintenance and procurement.

  1. What happens if this part is not replaced? Derated output, a forced stop, or a risk of damage to other components? The answer sets your deadline.

  2. How does this part usually fail? A part that wears predictably gives you a window. A part that fails suddenly does not.

  3. Can the function be isolated or carried by another circuit? Sometimes a unit can run in a reduced configuration while you wait.

  4. What would failure of a wrong part cost? On a small consumable, a trial is cheap. On a component that can damage the engine, the cost of being wrong is far larger than the saving.

  5. Can you verify the alternative before it goes in? If you cannot check it, you are not comparing options, you are guessing.

A useful rule from our own order desk: the more a part can damage around it, the more evidence you should require, and the more willing you should be to keep waiting.

If you choose an alternative, verify these first

Verification is the part buyers skip when they are in a hurry. It is also the part that decides whether the decision looks good in six months.

  • Match the part to the engine, not to a catalogue. Work from the nameplate, the engine serial number and the manufacturer's documentation. Identical engine families can carry different components.

  • Cross-check the reference. Compare the part number on the old part with the number being offered, and ask the supplier to explain any difference.

  • Check fit, form and function separately. Mounting dimensions and interfaces, materials and construction, and the duty the part has to perform. A part can match on two of the three and still be wrong.

  • Ask what records exist. At Weyeah Power, each batch and the dimensions of each product are inspected and recorded in our PLM and warehouse systems, so records can be traced.

  • Plan the first service interval around it. Note the installation date and running hours, and inspect at the next opportunity rather than waiting for the normal interval.

  • Keep the paperwork. Record what was fitted, why, and who approved it. This matters most when the engine is under a service agreement.

Warranty depends on the product. Check the product manual for the warranty that applies to your part, and check your engine's service agreement before fitting anything other than a genuine part.


How we handle urgent requests

We are an independent gas engine spare parts supplier. We do not claim OEM manufacturer status or authorization, and we will tell you when the honest answer is that you should wait for the genuine part.

For requests where the engine is down or close to it:

  • Orders normally ship within one week. When the part is in stock, an urgent order can ship the same day.

  • Lead time for custom items is confirmed with our sales team.

  • We cross-check the part against your engine model and serial number before quoting, so you are not comparing a price against the wrong item.

If you want the background on how orders are prepared and shipped, see how our delivery system works.

To help us check your part quickly, please include your engine model and serial number (or a nameplate photo), the part number or a clear photo of the old part, the quantity, the date you need the parts, and whether the engine is still running.

Frequently asked questions

How long is "too long" for a gas engine part?

There is no fixed number. A lead time is too long when it runs past the point at which the engine must stop, or past the end of your next planned outage. Work out that date first, then compare it with the quoted date. A long wait on a planned replacement is usually not a problem at all.

Will fitting an aftermarket part affect my engine warranty?

It depends on your agreements, not on the part alone. Warranty terms for the part itself are in the product manual. Separately, your engine warranty or service contract may set conditions on which parts can be fitted and by whom. Read both before you decide, and keep a record of what was installed.

Can I mix genuine and alternative parts on the same engine?

Many operators do, deciding component by component rather than for the whole engine. The usual pattern is to keep genuine parts where failure could damage surrounding components, and to consider alternatives on items that are easier to verify and inspect. Verify each part on its own merits and document what was fitted.

Is a reconditioned part a safe way to shorten a lead time?

It can be, if you know what was done to it. Ask which parts were replaced, what was measured against what criteria, who released the component, and what warranty applies. Condition and workmanship vary widely between suppliers, so the answers matter more than the price.

What do you need from me to quote an urgent part?

The engine model and serial number, or a photo of the nameplate; the part number, or a clear photo of the old part; the quantity; and the date you need it. Tell us whether the engine is running, because that changes which options are worth quoting at all.

Product Category

Related Products
The Jenbacher rotocap with the number 578817 is a part used in Jenbacher 6-series gas engines. The term "rotokap" usually means a mouth guard made of a rotor or a mouth guard that provides protection and flow control within the engine system.
Rotocap 578817 is suitable for Jenbacer type 6
$63.41
$63.41
Transmitter 12321982 for MWM gas engine
$253
$253
Seal-O-Ring 9M-9780 fits CAT G3520C
$124.13
$124.13
TBD620 air filter 12303447
$145.1
$145.1
Wartsila L20 Engine Spare Parts Screw 167008
$9.36
$9.36
TPS52-F32 turbocharger replacement fit for MWM,Jenbacher,Caterpillar gas engine
$26500
$26500

Quick links

Leave a Message
Inquiry

Product category

Contact us

 +86-18064047867
 info@weyeahengine.com
 1st Floor, Building 3, No. 6 Songgang Road, Panlongcheng Economic Development Zone, Huangpi District, Wuhan, China

Global after-sale service hotline:

Complaints and suggestions:

Wuhan Weyeah Power Machinery Co., Ltd. All rights reserved. Supported by leadong. Sitemap.
GE Jenbacher, MWM, Caterpillar, Deutz, MAN B&W, MTU, Wartsila are registered trademarks owned by their manufacturers.
