A practical checklist for operators and maintenance contractors
Prepare gas engine maintenance spare parts by identifying the engine, agreeing the work scope and building a parts list that can be checked before purchase. Separate confirmed replacements from items awaiting diagnosis or inspection, then verify quantities, kit contents, stock and delivery dates. Each engine configuration needs its own fitment check.
This checklist is for operators and maintenance contractors working with industrial gas engines used in natural gas and biogas power generation, including combined heat and power (CHP) plants. It covers procurement planning; the applicable manufacturer's manuals determine maintenance requirements and procedures.
1. Record the engine model, serial number and configuration.
2. Agree the maintenance scope and identify items awaiting inspection.
3. Build a preliminary parts list and reconcile kits, quantities and usable stock.
4. Review the list with the maintenance contractor and send the enquiry.
5. Confirm fitment, supply details and delivery dates before placing orders.
6. Inspect and stage delivered parts, then complete the parts-readiness check for the outage.
A brand or series name alone is insufficient to confirm a complete maintenance list. Collect the following information and keep a copy with the enquiry:
Manufacturer, full model and variant, such as the applicable Jenbacher J420 or J620 version, or MWM TCG 2020 variant.

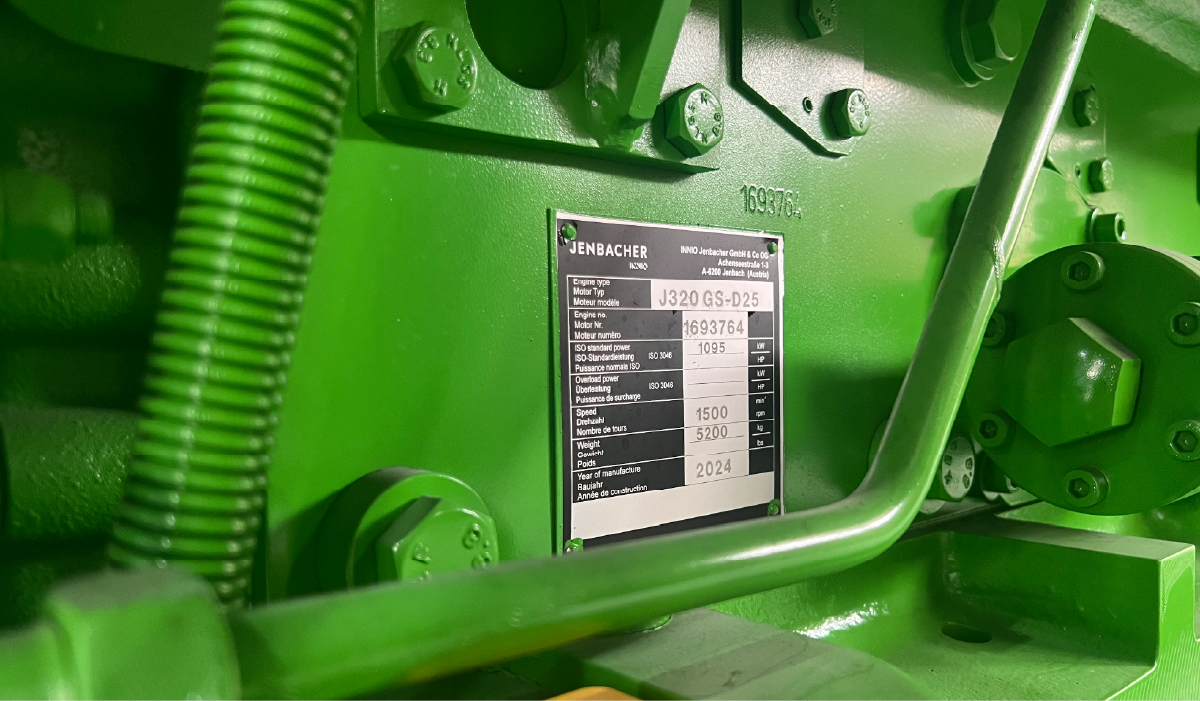

Engine serial number, equipment identifier and a legible nameplate photograph.
Relevant configuration details, including cylinder count, ignition version and recorded modifications; include gas-train or alternator data when those systems are in scope.
Fuel gas type, application, operating hours, previous maintenance records and the planned work scope.
Applicable parts catalogue or bill of materials (BOM), maintenance schedule and document revision.
Use the serial number and configuration together to check the documentation. If a part number has been replaced by a newer number, request the documented supersession and verify that it applies to the engine. A similar description or appearance does not establish interchangeability.
Mark each line as confirmed, pending diagnosis or inspection, or excluded from this event. Confirmed replacements may come from the applicable maintenance schedule, an agreed overhaul scope or an established fault. Other requirements may be identified through condition monitoring or pre-outage checks; some remain uncertain until disassembly and measurement.
For every pending item, record the decision criterion, the applicable manual reference and who will confirm the result. Request availability and quotation terms in advance where useful, while keeping conditional items separate from the approved order. Do not substitute generic online service intervals for the schedule that applies to the unit.
Use these categories to review the scope, not as a universal shopping list. The actual parts, quantities and replacement criteria depend on the engine configuration and approved maintenance work.
Category | Typical items | Planning check |
|---|---|---|
Filtration | Air, lubricating-oil and fuel-gas filters or cartridges | Confirm specifications and quantities against the applicable schedule and scope. |
Seals and gaskets | O-rings, gaskets and sealing kits for affected assemblies | Check replacement requirements and what each kit includes before ordering loose items. |
Ignition | Applicable spark plugs, prechamber spark plugs and ignition leads | Use the correct part numbers and replacement criteria for the engine and fuel. |
Fluids and sampling supplies | Approved lubricating oil, coolant and sampling bottles where required | Confirm fluid approvals, fill quantities and test requirements; list laboratory services separately. |
Major wear components | Cylinder liners, pistons, bearings and valve-train components | Confirm from the applicable overhaul scope, maintenance plan and inspection findings. |
Controls and sensors | Sensors, wiring and control modules | Confirm the diagnosis, hardware version and any configuration requirements. |
Check quantities for each engine first; multiply only across units with the same confirmed requirement. Compare the kit packing list with the BOM and mark components already included in a kit. This prevents ordering a sealing kit and the same loose seals twice, or assuming that a kit covers hardware it does not contain.
Count only usable stock allocated to this event. Check part-number revision, condition, storage requirements and shelf life where applicable. Deduct confirmed incoming quantities only if they are allocated to the job and expected before the required date. Keep pending inspection items separate from the confirmed demand calculation.
Quantity to purchase = max(0, confirmed demand + agreed contingency allowance − usable allocated stock − confirmed on-time incoming quantity)
For example, an illustrative line with demand of 12, an agreed allowance of 1, usable stock of 3 and confirmed incoming stock of 2 gives a purchase quantity of 8. This is a calculation example, not a parts recommendation for any engine model.
Complete the record below for each part or kit. Use one consistent unit of measure and identify the engine or group of verified identical configurations to which the record applies. Copy it for the next line item.
Ask each supplier to identify the actual brand, manufacturer, part number and condition, including whether the item is new, remanufactured or used. If a quotation uses terms such as genuine, OEM-sourced or alternative, request a clear explanation and supporting documentation. An original equipment manufacturer (OEM) label alone does not confirm source or fitment.
Compare the same scope: individual parts versus kits, quantities and units, included seals and hardware, required records, quoted delivery terms, freight, taxes and any core-return conditions. Request material or conformity certificates only where the specification or contract requires them, and verify that any certificate relates to the supplied item.
Plan delivery against the maintenance due date, the site's operating constraints and the contractor's availability. Before finalizing the outage arrangements, review critical parts and unresolved inspection items together. Do not assume that filters, seals or ignition parts are immediately available; lead time must be confirmed for each part number and quantity.
Distinguish the supplier's dispatch date from arrival at the site. Account for transport, customs where applicable, receipt inspection and staging.
Check delivered part numbers, quantities, condition, packaging and required documents against the order. Record discrepancies before release to the job.
For critical pending items, establish the decision owner, supplier contact and response options before inspection. Any backup part or source still needs fitment verification.
Agree contingency stock using failure history, replenishment time, storage limits and the consequence of a shortage, rather than stocking every expensive component.
A shortage found after disassembly can extend a planned outage. Close the parts-readiness review with the operator and contractor, documenting unresolved items and their effect on the work plan.
MWM's published product information distinguishes E40 maintenance bundles for the TCG 2016, TCG 2020 and TCG 3016 series from E40+ bundles for the TCG 2032 series. Its tables show different contents or quantities by cylinder count for the listed E40 series. Check the current MWM maintenance bundle information and confirm the applicable bundle for the engine before ordering.
Jenbacher's spare parts and consumables page describes its product range, including filters, seals, ignition components and lubricants. It is not a serial-number-specific maintenance BOM. Obtain the applicable parts documentation and verify the quantities, kit coverage and replacement requirements for the unit.
Weyeah Power's Jenbacher spare parts and MWM spare parts pages show its listed product ranges. Confirm fitment, the actual supply source and availability for each quoted item; a category listing is not confirmation of stock or compatibility.
Weyeah Power is an independent gas engine spare-parts trading supplier supporting operators of Jenbacher, MWM, Caterpillar and other gas engine fleets. We do not claim OEM manufacturer status or authorization. Part fitment and supply details require confirmation for the relevant engine and item.
What if the part number is missing?
Provide the full engine model, serial number, nameplate photograph and maintenance scope. Add available catalogue references and clear photographs of the old part and its markings. Use these to support identification; obtain documented confirmation of the part number and fitment before ordering.
Can one maintenance kit cover every engine in a series
Do not assume so. Confirm the variant, cylinder count, configuration and maintenance scope against the kit specification. Compare the kit contents with the job's BOM, including companion seals and hardware, and list any extra items separately.
How should parts awaiting inspection be planned
Keep a separate conditional list with decision criteria, the reviewer and the expected decision point. Obtain preliminary quotations and supply options where possible. Confirm reservation, cancellation or return terms with the supplier rather than assuming they are available, and release purchases according to the agreed approval process.
Which spare parts should be kept on site
Prioritize approved recurring consumables and items whose absence would cause an unacceptable delay. Consider failure history, confirmed replenishment time, storage conditions, shelf life and available alternatives. Review stock after each event so that obsolete, damaged or already allocated parts are not counted as usable inventory.
